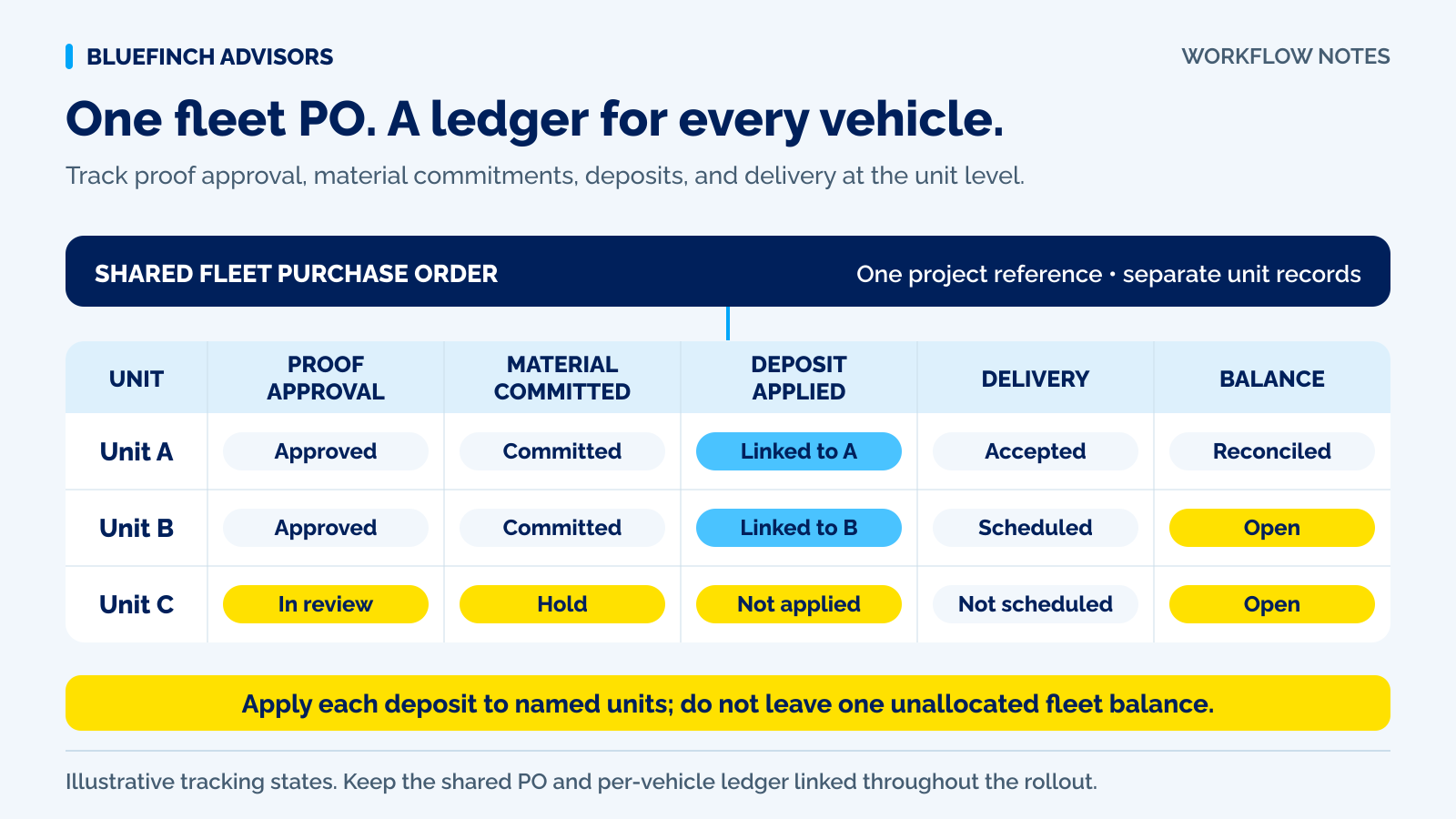

Fleet wrap rollout linking one corporate purchase order to separate vehicle proofs, deposits, installation records, and balances
BlueFinch original workflow diagram

The short version

  • Give every vehicle its own scope, proof version, and payment allocation.
  • Separate a corporate PO or approved credit terms from money received.
  • Reconcile phased collections without applying the project deposit twice.

A fleet approves four vans, but only two arrive this week. The next van has a different roof height, and the last one is waiting for repair. Your project total still looks simple. Material orders, installation slots, and collections no longer follow one date.

Build a per-vehicle ledger under the fleet account. The buyer gets one coordinated rollout, while your team sees which proof was approved, which film was committed, and which balance belongs to each delivery.

Use with this guide

Job cash-flow planner

Map cash committed and payments collected across a project's milestones.

Fleet invoice checklist

Prepare the approval, vehicle, purchase-order, and billing records before an invoice reaches accounts payable.

Vehicle wrap film roll planner for repeated rectangular panels

A roll purchase and the film consumed by a job are different costs. Plan identical rectangular cuts without rotating directional film.

Approve the rollout and each vehicle variant

Start with the fleet's billing name, project reference, vehicle list, quantities, and authorized buyer. Record whether one purchase order covers the rollout or separate orders cover each phase. Keep vehicle identifiers tied to the correct body style, coverage, and proof version.

SigmaGrafix describes a workflow moving from quote and deposit, or a PO for pre-approved clients, to artwork approval and production. That is an example of a real shop's process, not a universal deposit rule. For your rollout, say exactly what approval starts design, printing, material ordering, or installation scheduling.

Sources for this section: SigmaGrafix: deposit, artwork proof, and production workflow

Keep a condition record for every vehicle

A fleet logo approval does not describe the condition of each van. Attach the unit's inspection record, agreed removal or prep work, and any approved price change to that unit's order. If a replacement vehicle enters the rollout, confirm the new scope before reusing the old proof or payment request.

3M's July 2026 vehicle-application bulletin recommends a signed pre-installation inspection record for each vehicle. Your installer should follow the applicable manufacturer instructions. The office uses the record to connect the agreed job, any changes, and the final invoice, without treating a deposit as approval of an undocumented substitution.

Sources for this section: 3M: Application: Vehicles instruction bulletin, July 2026 revision

Write down how the project deposit is applied

A project deposit needs an allocation method. The agreement might apply a portion to each vehicle or reserve a balance for a defined stage. Whichever method applies, keep the amount received, amount applied, and amount still allocated to unfinished work visible.

A PO establishes a purchasing reference under the buyer's process. It is not a bank receipt. If the shop extends account terms, model the material and labor cash due before collections. A large authorized rollout still needs working cash while vehicles are being completed.

Worked example: four vans, two delivered

This fictional rollout prices four vans at $3,500 each, for $14,000 total. The agreed deposit is $600 per vehicle, or $2,400 received upfront. If material cash paid for all four totals $3,600, the initial cash gap is $1,200 before considering labor or other expenses.

Two vans are then completed and their $2,900 balances collected. Total receipts become $8,200: the original $2,400 deposit plus $5,800. The two unfinished vans still have $600 each allocated from the original deposit and $2,900 each remaining to collect. Do not apply the entire $2,400 again to the last invoice.

UnitAgreed priceDeposit appliedBalance status
Van 1$3,500$600$2,900 collected
Van 2$3,500$600$2,900 collected
Van 3$3,500$600$2,900 remaining
Van 4$3,500$600$2,900 remaining

Make completed units easy for accounts payable to approve

Confirm the buyer's required completion packet before the first delivery. Visual Marking Systems' installer submission form asks for installation photos, vehicle-identification photos, the PO number, and an invoice before processing payment. Its requirements show why completed graphics and a payable invoice are separate milestones.

For your buyer, agree which records belong to each unit and who accepts them. Submit the phase invoice with the correct PO and applied deposit. Track submission, acceptance, and collection dates. Keep a delayed vehicle from obscuring the status of completed vehicles when the agreement allows phased billing.

Sources for this section: Visual Marking Systems: fleet graphics installer payment documentation

Print the fleet rollout ledger

Use one sheet per fleet project and one row per vehicle. Attach the proof and acceptance references to the unit record. Add rows for substitutions or approved changes instead of overwriting the history.

Vehicle / proof / PO referencePrice / deposit allocatedDelivery / remaining collection
Unit 1: ___________________$________ / $________________________
Unit 2: ___________________$________ / $________________________
Unit 3: ___________________$________ / $________________________
Unit 4: ___________________$________ / $________________________
Change: ___________________$________ / $________________________
Project totals: ___________$________ / $________________________

Free to download without an email address. Fill in business or customer details only in your own records.

Download worksheet (CSV) ยท Open print version

Agree corporate payment choices before production

Discuss accepted methods and pricing with the authorized buyer before committing to the order. A driver collecting a finished van should not face a new price because accounts payable plans to use a corporate card. Confirm any dual-pricing arrangement against the contract and approved processing setup.

At project close, reconcile approved charges, received deposits, phased collections, credits, and the remaining balance. Keep the final account statement short enough for the buyer to match each line to a vehicle.
